What lead time is

Lead time is the total time from the moment a customer places an order until the product is delivered. It is the delay the customer actually sees, which is why it is so closely tied to customer satisfaction and competitiveness.

Lead time adds up everything along the way: order processing, queues, production, inspection, packaging and transportation. In most plants the largest share of that time is not work but waiting, so cutting lead time almost always starts with attacking queues and inventory between steps.

Lead time visual map

The map sums up the types of lead time, a 10-day order-to-delivery example, the usual causes of long lead times and the steps to reduce them.

Lead time visual map: types of lead time, a 10-day example, process steps, causes of delay and how to reduce it

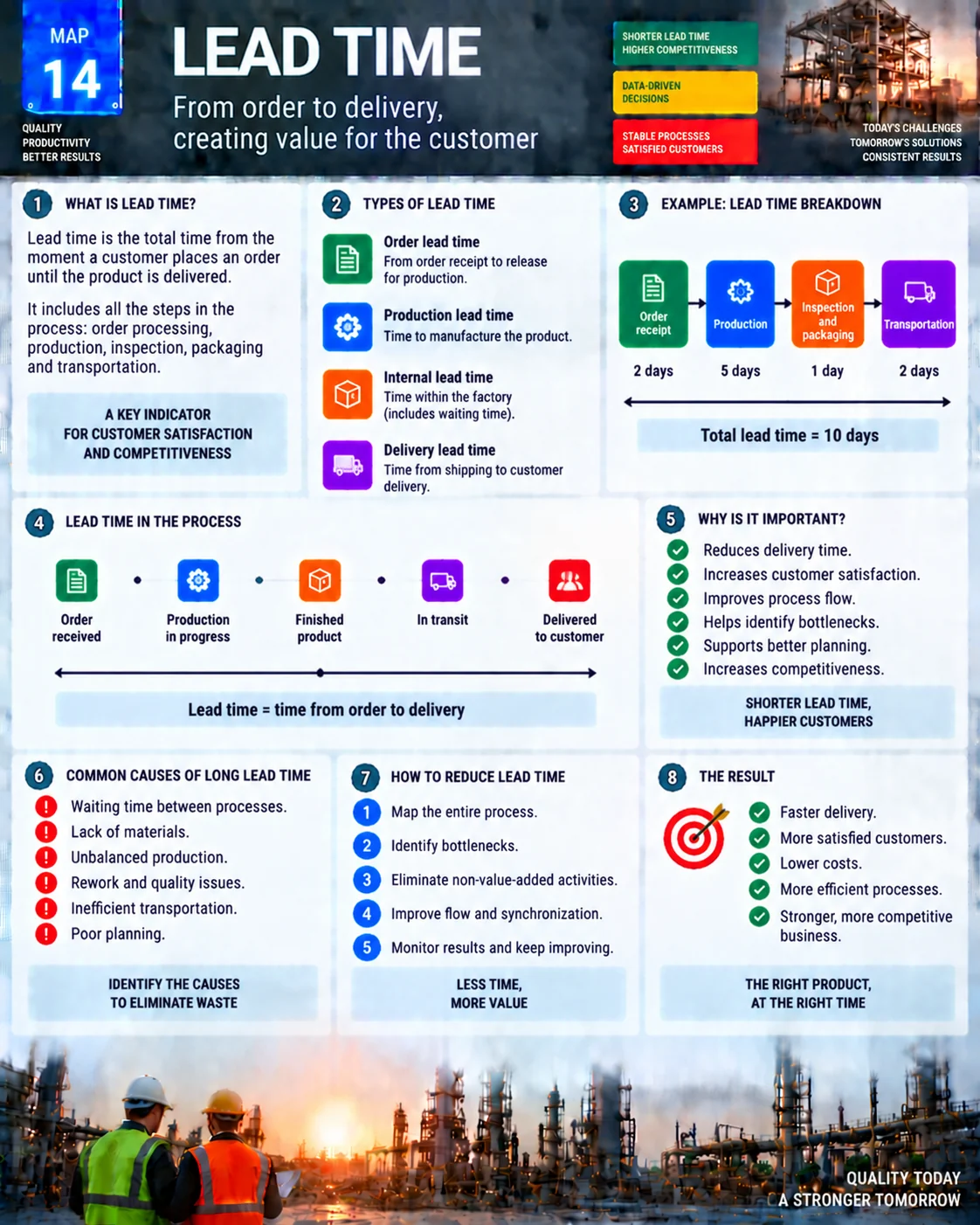

Visual map 14: lead time. Click the map to open it full size.Download the map as PNG

Types of lead time

TypeFrom what to what
Order lead timeFrom order receipt to release for production
Production lead timeFrom work order release to finished product
Internal lead timeAll time inside the plant, including waiting
Delivery lead timeFrom shipping to receipt by the customer
Replenishment lead timeFrom the purchase order to material available

The last one is invisible to the customer, but it sets the reorder point and safety stock, as explained in the inventory management guide.

How to calculate lead time

Total lead time = sum of the time of every step, including waiting

In the map's example, the order takes 2 days to be received and released, 5 days in production, 1 day in inspection and packaging, and 2 days in transportation. Total lead time is 10 days.

StepTime
Order receipt2 days
Production5 days
Inspection and packaging1 day
Transportation2 days
Total10 days

Measure it with real timestamps: when the order enters the system and when delivery is confirmed. Track the average and the spread, because customers feel the variation more than the average.

Little's Law: work in process becomes lead time

Little's Law, proven by John Little in 1961, links three numbers in any stable process:

Lead time = work in process ÷ throughput

With 300 parts in process and a plant shipping 60 parts per day, each part needs on average 300 ÷ 60 = 5 days to get through production, exactly the production lead time in the example. Without adding capacity, the fastest way to cut lead time is to cut work in process, with smaller lots and pull production.

Lead time vs cycle time vs takt time

ConceptWhat it measures
Lead timeOrder to delivery, from the customer's point of view
Cycle timeInterval between two parts leaving an operation or process
Takt timeProduction pace required by customer demand
Value-added timeThe part of lead time in which the product is actually transformed

These terms are often mixed up. Takt time comes from demand, cycle time comes from the process, and lead time is the result the customer feels. The Lean Enterprise Institute lexicon has the reference definitions.

Advertisement

Common causes of long lead times

How to reduce lead time

  1. Map the entire process. Value stream mapping shows a timeline of processing and waiting.
  2. Find the bottleneck. The Theory of Constraints shows that queues build up in front of it.
  3. Eliminate non-value-added activities such as moves, waiting for approvals and duplicate inspections.
  4. Shrink lot sizes with quick changeover (SMED) and pull production with kanban.
  5. Improve flow and synchronization between sales, planning, production and shipping.
  6. Monitor results and keep improving.

Industrial examples

Common mistakes and checklist

Frequently asked questions

What is lead time?

The total time from the customer's order to delivery of the product, adding up processing, waiting, production, inspection and transportation.

How do you calculate lead time?

Add up the time of every step, including queues and waiting. In the example, 2 + 5 + 1 + 2 days give 10 days.

What is the difference between lead time and cycle time?

Lead time is the total order-to-delivery time; cycle time is the interval between two parts leaving a process.

How can lead time be reduced?

Map the flow, attack the bottleneck, reduce lot sizes and work in process, eliminate waiting and pull production.

What does Little's Law say?

Lead time equals work in process divided by throughput, so less work in process means shorter lead time.

Sources

  1. LITTLE, J. D. C. A proof for the queuing formula L = λW. Operations Research, 9(3), 1961.
  2. ROTHER, M.; SHOOK, J. Learning to See. Cambridge, MA: Lean Enterprise Institute.
  3. Lean Enterprise Institute. Cycle Time. https://www.lean.org/lexicon-terms/cycle-time/
  4. Lean Enterprise Institute. Value Stream Mapping. https://www.lean.org/lexicon-terms/value-stream-mapping/
