Cover image: a newly installed CNC machine on a factory floor with engineers reviewing an investment project.

What CAPEX and capital budgeting are

CAPEX (capital expenditure) is spending on long-lived assets such as machines, buildings and systems that deliver benefits for several years. Capital budgeting is the process of planning, evaluating, approving and tracking that spending so money goes only where the return covers the cost of capital.

This article covers the process and decision criteria on the plant side. The evaluation math itself is in NPV, IRR and payback; here it is applied to a complete project.

Advertisement

Visual map of capital budgeting

The map shows the steps from need to approval, the investment breakdown and the result of the $600,000 example.

CAPEX AND CAPITAL BUDGETING

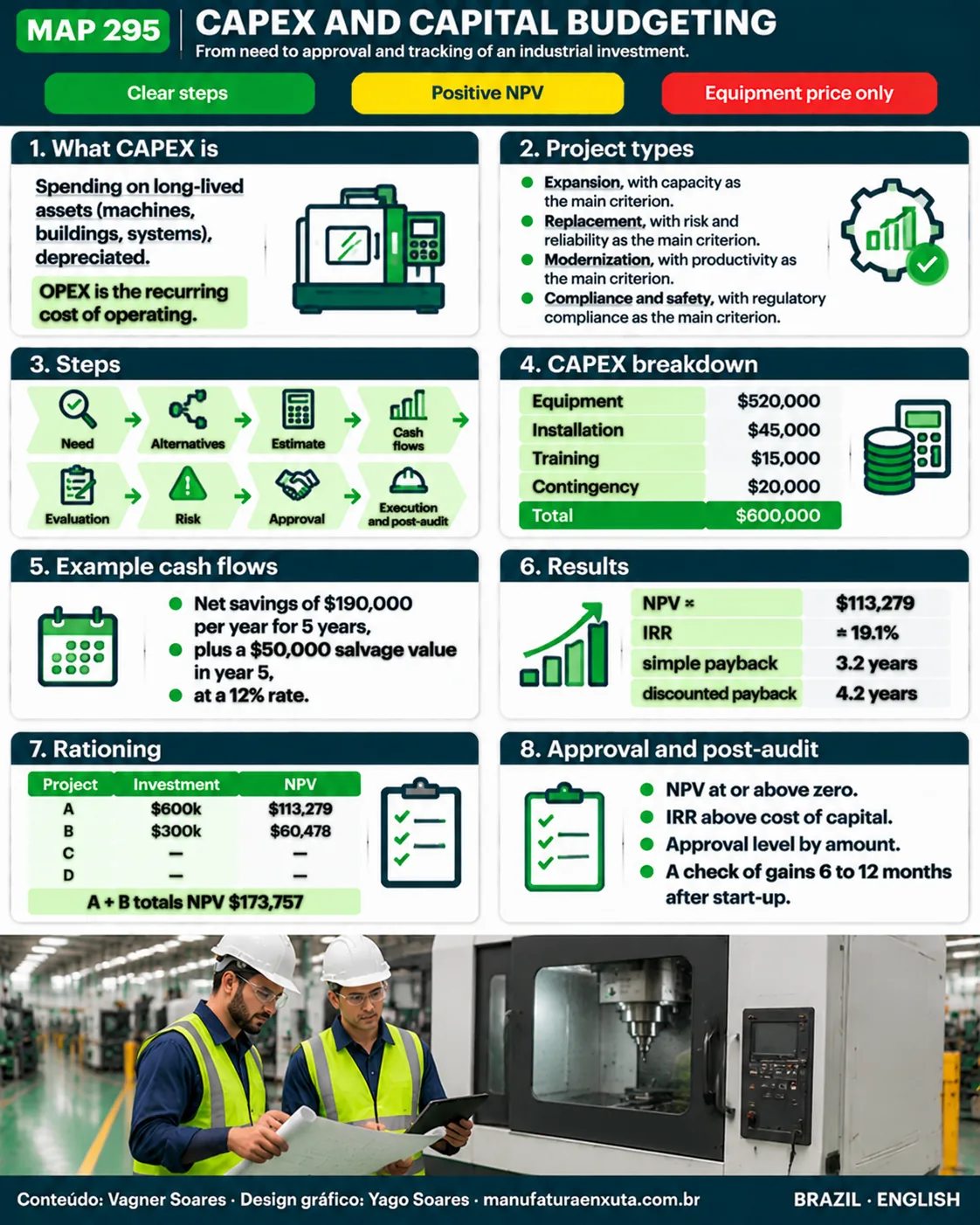

Visual map 295: Capital Budgeting and CAPEX in Industrial Projects. Click the map to see it full size.Download the map as PNG

CAPEX vs OPEX and project types

OPEX is the recurring cost of running the plant (energy, labor, routine maintenance); CAPEX creates or expands an asset. The line matters because CAPEX is depreciated and goes through formal approval. Industrial projects usually fall into four groups:

TypePurposeExampleMain criterion
ExpansionAdd capacitySecond filling lineNPV and capacity actually sold
ReplacementKeep what exists runningReplacing a press at end of lifeLowest life-cycle cost
ModernizationCut cost or improve qualityMachining center with quick changeoverNPV, IRR and payback
Compliance and safetyMeet a regulation or remove a hazardMachine guarding, fume extractionLegal obligation; lowest-cost alternative

For replacement projects, compare alternatives on total cost of ownership, not just purchase price.

Steps of capital budgeting

  1. Need: describe the problem (bottleneck, cost, risk, regulation) with data, not the solution.
  2. Alternatives: always include "do nothing" and at least one lower-cost option.
  3. Investment estimate: add everything needed for the asset to run (see the example below), with contingency.
  4. Incremental cash flows: savings and added revenue minus added costs and taxes, year by year.
  5. Evaluation: NPV, IRR, simple and discounted payback, using the company hurdle rate.
  6. Risk: test pessimistic and optimistic cases; see investment sensitivity analysis.
  7. Approval: at the authority level matching the amount, within the annual budget or as an extraordinary request.
  8. Execution and tracking: compare actual spend with budget and deliver the asset on schedule.
  9. Post-audit: 6 to 12 months after start-up, check whether the expected gains happened.
Advertisement

Investment breakdown

The most common error is approving only the equipment price. The (fictional) example below shows a CNC machine for a modernization project:

ItemAmount
Equipment (purchase price)$520,000
Installation, foundation and electrical infrastructure$45,000
Training and start-up$15,000
Contingency (about 3.3% of the total)$20,000
Total investment (CAPEX)$600,000

Additional working capital, if any, enters the year-0 cash flow and is recovered at the end. For that effect, see the cash conversion cycle and working capital.

Worked example: a $600,000 CNC machine

The machine cuts machining cost and frees capacity hours, giving net after-tax savings of $190,000 per year for 5 years and a salvage value of $50,000 at the end of year 5. The hurdle rate is 12% per year.

YearCash flowPresent value (12%)Cumulative cash flow
0−600,000−600,000−600,000
1190,000169,643−410,000
2190,000151,467−220,000
3190,000135,238−30,000
4190,000120,748160,000
5190,000 + 50,000 = 240,000136,182400,000

NPV = −600,000 + 169,643 + 151,467 + 135,238 + 120,748 + 136,182 ≈ $113,279

Present values are rounded; the exact sum is $113,278.82. At a 20% rate the NPV is already about −$11,700: the project's safety margin lies between 12% and 19%.

Capital rationing: when the budget does not cover everything

If four projects compete for $1,000,000, NPV alone is not enough. Rank by profitability index (NPV ÷ investment) and pick the combination with the highest total NPV within the limit:

ProjectInvestmentNPV (12%)NPV ÷ investmentIRR
A (CNC)600,000113,2790.18919.1%
B300,00060,4780.20219.9%
C450,00018,6210.04113.7%
D250,000−33,713−0.1356.4%

Project D destroys value and drops out. A + B uses $900,000 for a total NPV of $173,757; B + C uses $750,000 for $79,099. A + B is the best feasible combination, and the remaining $100,000 waits for the next cycle. For indivisible projects, test combinations rather than just ranking.

Decision and approval criteria

Common mistakes

Frequently asked questions

What does CAPEX mean?

Capital expenditure: spending on long-lived assets such as machines, buildings and systems that deliver benefits for several years and are depreciated.

What is the difference between CAPEX and OPEX?

CAPEX creates or expands an asset and is depreciated; OPEX is the recurring cost of operating, such as energy, labor and routine maintenance.

What goes into a project investment?

Equipment, installation, infrastructure, training, start-up, contingency and, if any, additional working capital. In the example, $600,000 in total.

Which criterion should approve a project?

NPV at the hurdle rate is the central criterion. IRR, payback and profitability index support it. In the example, NPV of $113,279 and IRR of 19.1%.

How do I decide when the budget is smaller than the sum of projects?

Drop projects with negative NPV, rank by NPV ÷ investment and test combinations within the limit. In the example, A + B ($900,000) gives the highest NPV.

What is a post-audit for?

It compares actual results with the forecast 6 to 12 months after start-up and improves the estimates of future projects.

Advertisement

Sources

  1. Richard Brealey, Stewart Myers and Franklin Allen. Principles of Corporate Finance. McGraw-Hill.
  2. Stephen Ross, Randolph Westerfield and Jeffrey Jaffe. Corporate Finance. McGraw-Hill.
  3. Lawrence Gitman. Principles of Managerial Finance. Pearson.
  4. Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK Guide). PMI.

Keep studying: trusted sources and links

Save this address: Manufatura Enxuta is your school for lean manufacturing. Come back whenever you need to study, with a complete article, a visual map and trusted sources. Follow one of the learning paths or check the A–Z glossary.

Want to measure what really matters?

Download the free e-book on performance indicators and track the losses in your operation.

Download the e-book
Photo of Vagner Soares

About the author

Vagner Soares

Lean Manufacturing & Behavioral Management Specialist

Over 20 years in the automotive and metalworking industries (GM and Dana), Lean Manufacturing practitioner since 2006. SENAI instructor and mentor in Brazil’s Brasil Mais Produtivo program, delivering consulting, training and audits for 50+ companies, combining quality, productivity and people development.
